Construction Timeline

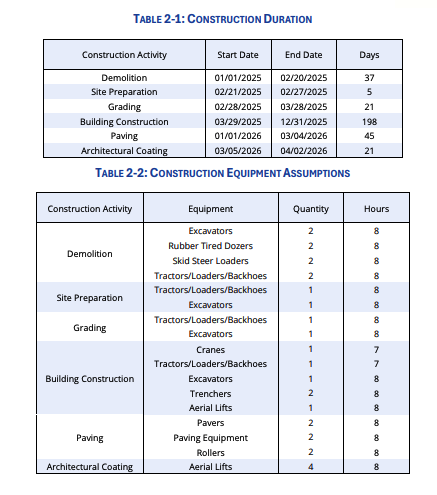

As discussed in the AQIA, the Project would result in approximately 1,169 total working-days of construction activity.  Clearly the dates are off, we want updated dates and hours of operation for construction and business operations since the tenant is speculative.  MAKE YOUR VOICE HEARD!

https://cms3.revize.com/revize/huntingtonbeachca/Appendix_A_AQ-HRA-Energy.pdf?t=202511061024500&t=202511061024500
